Three recent jobs, told the way they happened: what we were asked, what the check found, and the smallest change that fixed it. The images are from the actual analysis. Clients, sites and drawings stay private.
An existing steel cantilever rack: four frames, five levels, 1,000 kg per level. The working assumption was the load divided by four arms, 250 kg each. It was wrong three times over.
None of it meant a new rack. The arms were boxed with a second angle and welded for the real moment and twist, the base stiffened, the anchors placed where the lever is longest, the footing pads thickened, and a cyclone procedure written.
How the rack check works

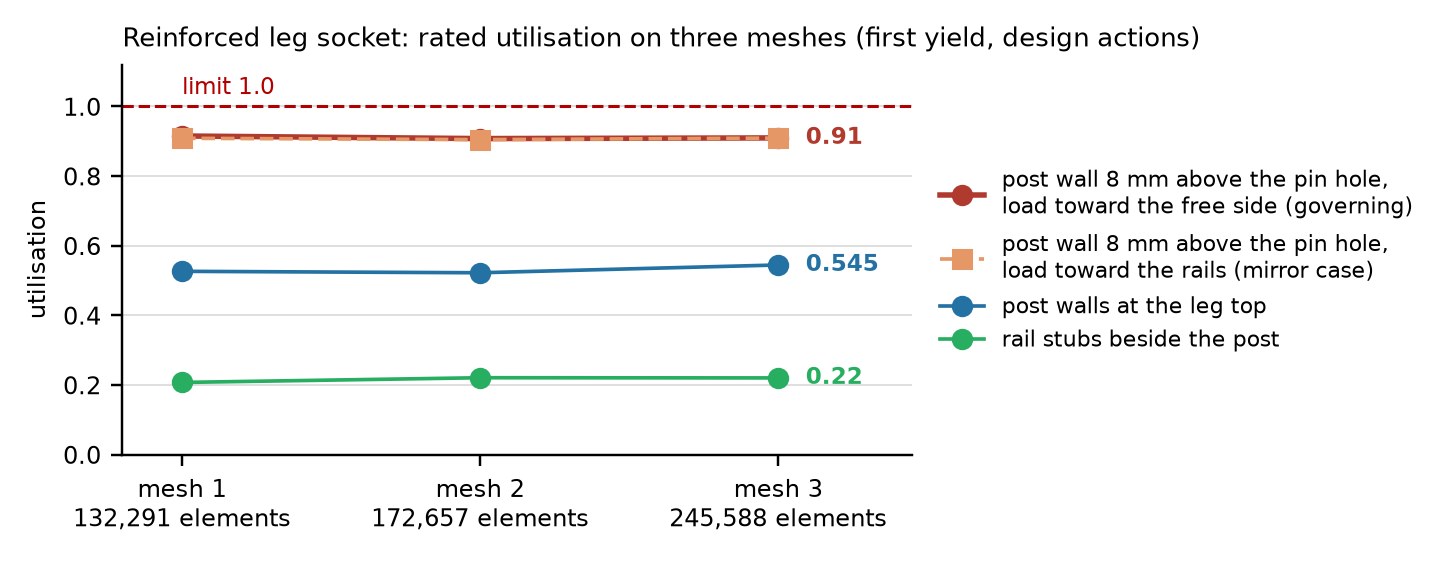

A client sent drawings of a mobile steel frame and one question. Before changing anything, we checked the design exactly as drawn: hand calculations to AS 4100 first, then finite element analysis on the parts the hand calculations flagged.

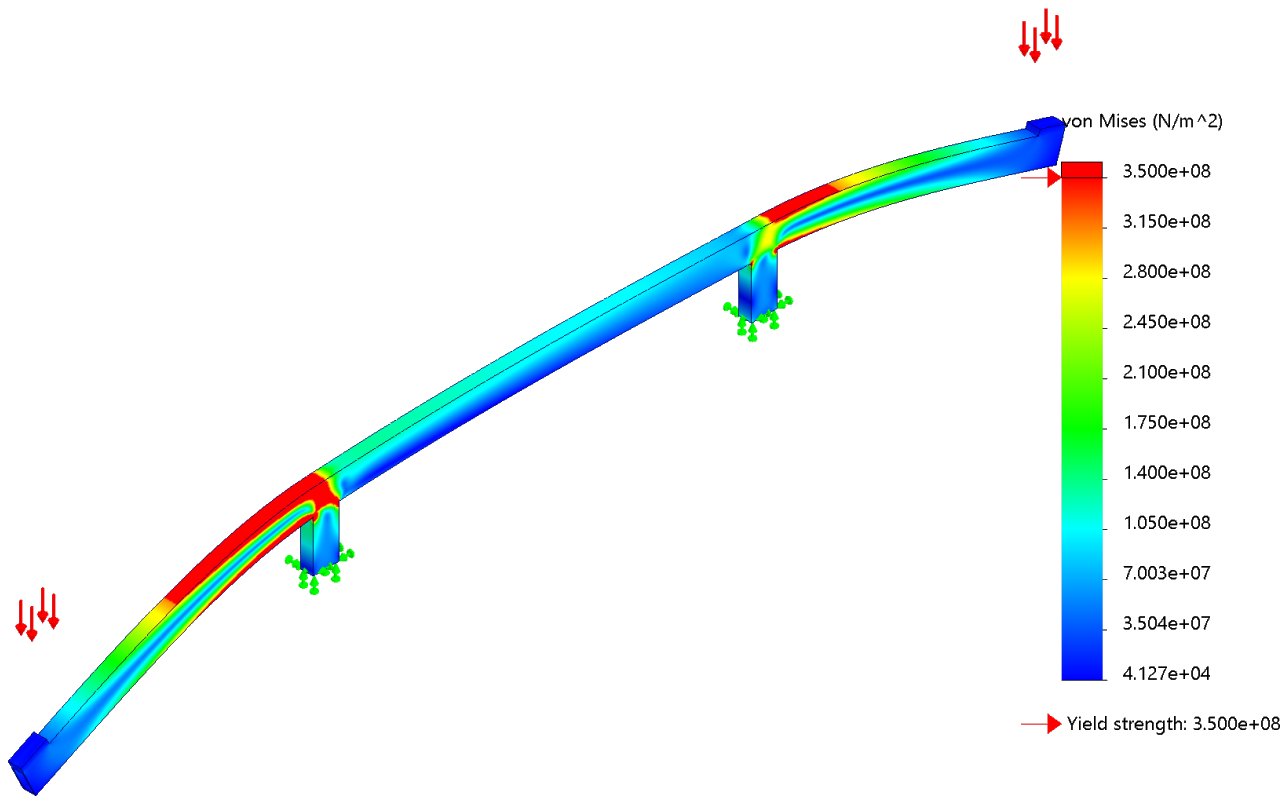

The first image settled it. One small RHS member, loaded the way the frame is actually used, past yield along a long band of its top and bottom faces. Not a hot spot at a sharp corner that can be argued away. That member had to change.
A colourful plot proves nothing until it agrees with a hand calculation and survives a mesh refinement.
Structural design and checks

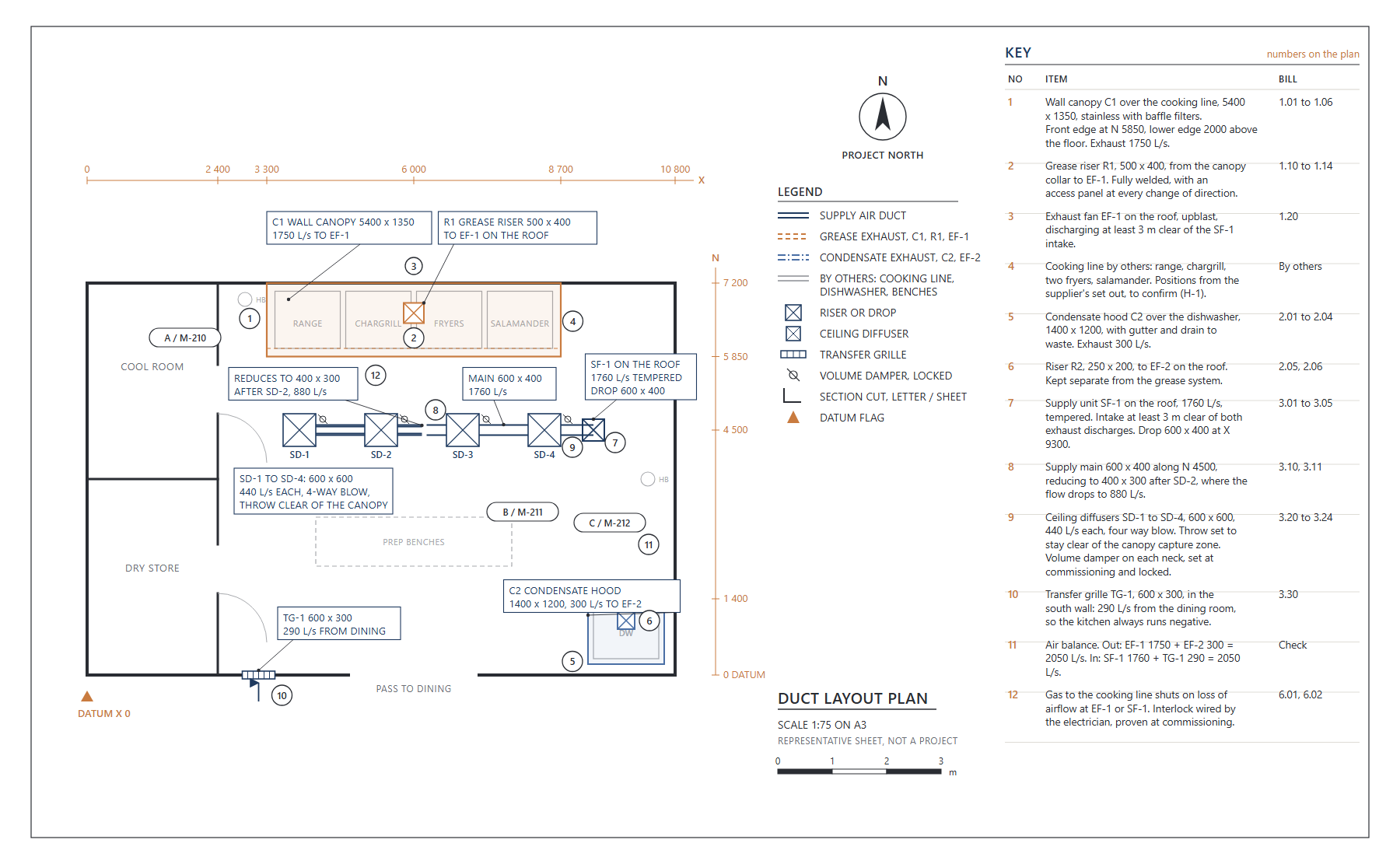

The first layout was the usual one: canopy, 20 m of grease duct across the ceiling, fan wherever the roof looked clear, a 3 m stack. It complied. It also carried assumptions the Standards do not support.
None of this is exotic. It is reading the clause, doing the arithmetic, and deciding before the contractor prices.
The seven decisions, with the numbers
Send the drawings or a few photos. Free scoping call, then a fixed fee before any work starts.
Send the drawings
